A major yacht rig refit is rarely defined by the work that takes place once the mast has been removed. By that stage, the project has often been developing for months while the yacht is still in operation, sometimes on the other side of the world.
Unlike many engineering projects, planning frequently begins without direct access to the asset itself. The yacht may still be completing a charter season, crossing an ocean or operating to a programme that cannot be interrupted. Decisions therefore have to be made using the best information available at the time; previous survey reports, inspections, certifications, manufacturer service histories, photographs, crew measurements, drawings and discussions with the captain, chief engineer, management company and owners’ representatives.
That information is enough to establish the initial scope, identify long lead-time components and begin coordinating manufacturers, survey attendance, crane bookings and shipyard schedules. It is not enough to define every engineering decision that will be made during the project.

Building the Initial Scope for a Yacht Rig Refit
Every refit begins with a planned scope of work, but the scope itself depends on the age of the yacht, the survey cycle and the owner’s operational requirements.
A five or ten-year yacht rig refit programme may include replacement of standing rigging, servicing furling systems, mast refurbishment, hydraulic overhauls, spar inspections, structural repairs, lifting equipment inspections, owner upgrades or modifications introduced since the yacht was originally commissioned. Increasingly, projects also include bespoke engineering where replacement parts are no longer available or where the original design no longer reflects how the yacht operates today.
At this stage, project planning is an exercise in balancing certainty with flexibility.
Materials and parts have to be ordered, manufacturers engaged and production slots secured, while recognising that some decisions cannot be made until the yacht has been dismantled. Every experienced project manager understands that there is a practical limit to what can be confirmed remotely.
Design and build drawings rarely account for modifications carried out during previous refits. Surfaces and structure that high load fittings and components are fastened to, often cannot be inspected without removal of the parts and material specifications and dimensions supplied years earlier may no longer represent the yacht accurately.
The programme begins with assumptions supported by evidence. As the project progresses, those assumptions are gradually replaced by facts found through the inspection process.
Unstepping The Mast

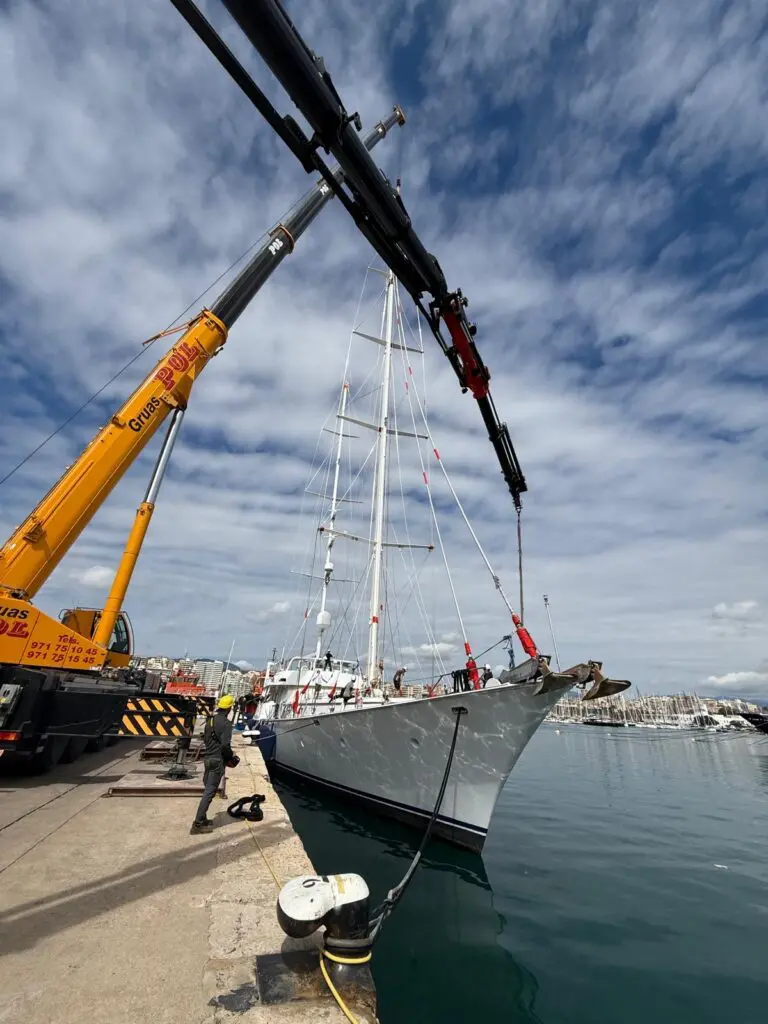

Removing the mast during the yacht rig refit marks the point where planning gives way to verification.

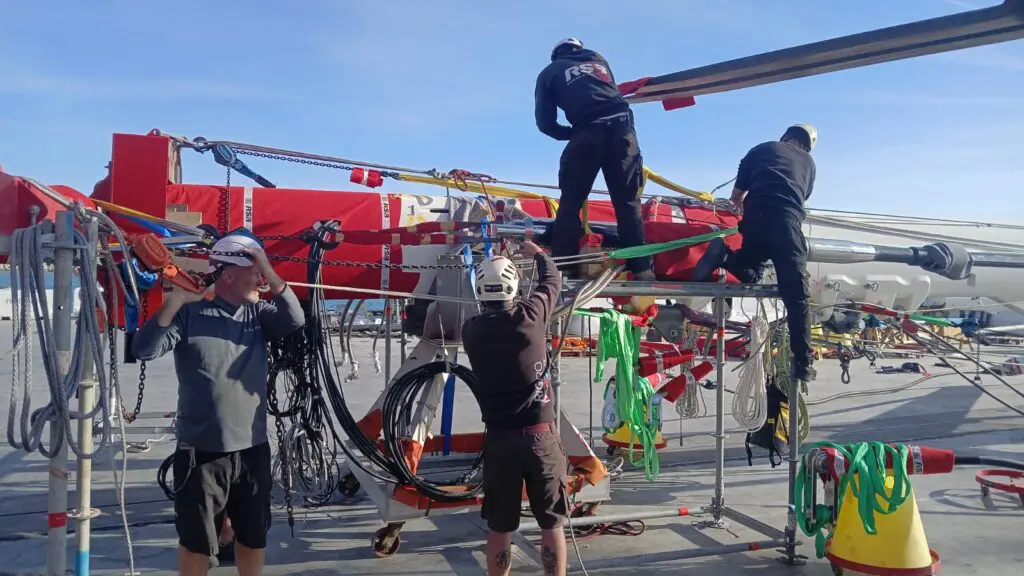

Once the rig has been dismantled, unloaded fittings and hardware can be inspected, dimensions can be confirmed and hardware that may not have been visible since the last refit or in some cases since the yacht was built, becomes accessible allowing it to be removed.
This is often where the programme begins to change.
Components expected to require replacement may prove entirely serviceable following detailed inspection. Equally, parts showing little evidence of deterioration externally can reveal corrosion, cracks, wear, movement or evidence of previous repairs once dismantled. Measurements taken directly from the yacht may differ from original construction drawings or records held by manufacturers, requiring machining drawings to be revised before production continues.
The ability to directly inspect the spars, hardware and associated fittings will always provide more information than can be ascertained from photos and planning carried out remotely.
Every major refit reaches the point where engineering decisions begin to rely less on documentation and more on the condition of the yacht itself.

Engineering Beyond Replacement
Modern refits increasingly involve engineering solutions rather than simple replacement.
Many yachts entering significant survey periods have been operating for decades. Sail inventories have evolved, hydraulic systems have been upgraded, lifting arrangements have changed and structural modifications introduced during previous yard periods have altered the original configuration.
Replacing a component like-for-like is not always appropriate.
The engineering process begins by assessing how the component functions within the complete structure rather than considering it in isolation. Existing load paths are reviewed, dimensions verified, material specifications agreed and manufacturing drawings produced using measurements taken directly from the yacht.
Where bespoke fabrication is required, machining is only one stage of the process.
Structural components, lifting equipment, spreader bars, mast fittings, padeyes and other load-bearing assemblies are inspected throughout manufacture before undergoing proof load testing. The objective is not simply to confirm that the fabricated component withstands the required load, but to validate the complete engineering process from design and material selection through to manufacture and final certification.
Only once those stages have been completed does the component become part of the yacht.
Managing Multiple Workstreams During a Yacht Rig Refit
By the midpoint of a major refit, the volume of activity taking place away from the yacht often exceeds the work alongside her.
Standing rigging may be progressing through service or replacement with specialist manufacturers while the spar undergoes structural repairs and repainting. Hydraulic systems are rebuilt, custom components move through machining, fabricated assemblies are prepared for proof load testing and survey attendance is coordinated around the completion of multiple independent activities.
Each of those workstreams influences the others.
A revised dimension identified during dismantling may require manufacturing drawings to be reissued before machining continues. A fabricated component cannot proceed to proof load testing until dimensional inspection has been completed. Survey attendance may depend on certification being available, while transport schedules, customs clearance and supplier lead times determine when components physically arrive at the yard.
It is not unusual for one change to alter several subsequent stages of the programme.
The work itself has not changed, but the sequence in which it is completed often has.
Human factors also become increasingly important as the project develops. Drawings are revised, information passes between manufacturers, machine shops, surveyors and the project team, while measurements, certification and inspection records have to remain consistent across every organisation involved.
Traceability is maintained throughout because each stage relies on the accuracy of the one before it.
Weather Is Another Engineering Constraint
Weather influences almost every major rig refit, although not simply because work stops when conditions deteriorate.
Crane operations are governed by operating limits. Paint systems require suitable environmental conditions for application and curing. Some inspections are better carried out before assemblies are exposed to the elements again, while sea trials depend entirely on achieving meaningful operating conditions rather than simply finding a calm day to leave the dock.
Weather therefore affects sequencing as much as progress.
One activity may pause while another moves forward. Workshop operations continue while lifting operations wait. Survey documentation can be completed while transport delays are resolved. Programmes adapt continually as conditions change, allowing work to continue without compromising engineering standards or safety.
No two winter refits experience identical conditions, and no two programmes respond in exactly the same way.
The ability to adjust the sequence without compromising the outcome becomes part of the project itself.
Commissioning Under Sail
Completing the work ashore does not conclude a major rig refit.
The commissioning programme begins once the yacht returns to the water, and its objectives depend entirely on the vessel, the scope of work completed and the information still required before handover.
There is no standard sea trial.
A cruising yacht returning from routine standing rigging replacement will follow a different programme to a performance yacht undergoing a complete ECsix service, while a racing yacht may require several tuning sessions across a range of wind strengths before the rig reaches its final settings. Hydraulic systems, furling equipment, sail handling systems and newly installed structural components all have their own commissioning requirements, and not every objective can be achieved during a single day on the water.
Weather becomes another variable.
An ideal programme would progressively introduce load across different sail plans and wind strengths, allowing rig tune, mast bend, forestay tension and sail shape to be evaluated methodically before final adjustments are made. In practice, commissioning is carried out in the conditions available, requiring the project team to balance engineering priorities with safe operating limits.

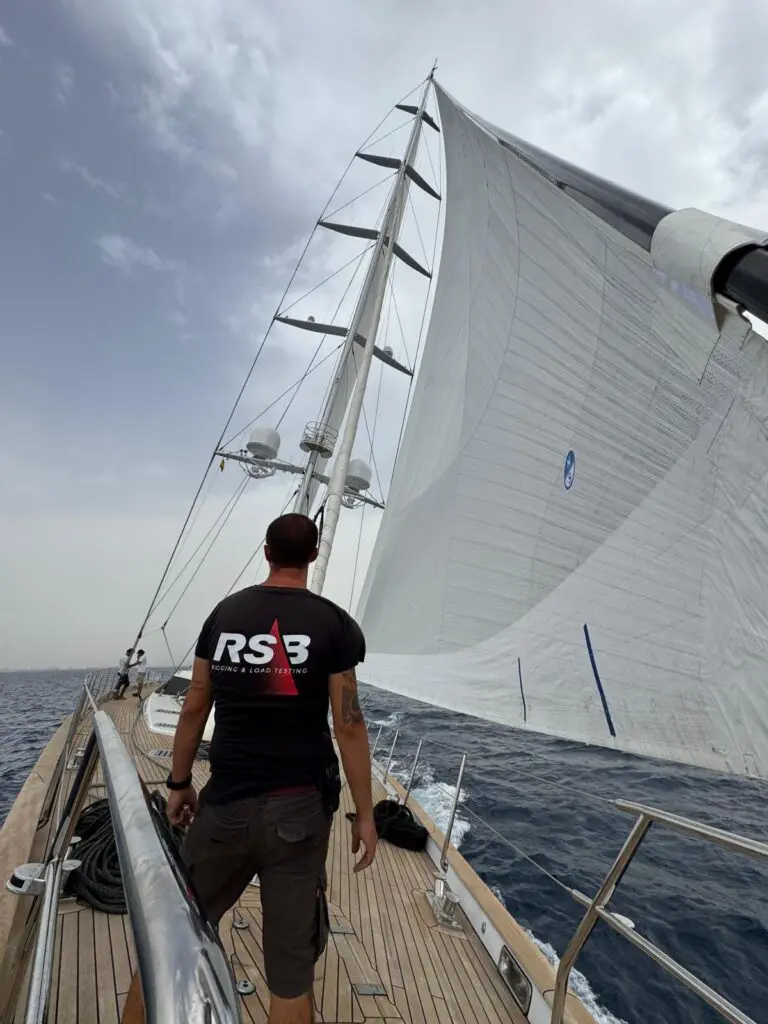

Nefertiti’s recent sea trials following her winter ECsix service illustrate this well. Forecasts suggested relatively moderate conditions suitable for initial commissioning, yet passing squalls quickly produced significantly higher loads than anticipated. Sailing with the first reef reduced sail area, allowing the standing rigging to be introduced progressively while rig tune, mast behaviour and sail shape were assessed as conditions changed. Rather than abandoning the trial, the programme adapted to the conditions, gathering valuable information before returning alongside for further refinement.
It is not unusual for commissioning to continue over several sailing sessions.
Final rig tune frequently develops as additional information is gathered under different sail combinations, points of sail and weather conditions. The objective is not simply to demonstrate that the rig functions correctly, but to confirm that it performs consistently throughout its expected operating envelope.

Documentation and Certification
A completed yacht rig refit is only one part of the yacht’s engineering history.
Inspection reports, proof load certificates, material certification, dimensional records, manufacturer documentation and survey reports all become part of the technical file supporting the yacht throughout the next service cycle. Those records establish traceability between inspections, demonstrate compliance with class and Flag State requirements and provide future project teams with an accurate record of the work completed.
Documentation is frequently underestimated until it is needed.
A component may have been inspected correctly, tested in accordance with the relevant standard and returned to service without issue. If the supporting records cannot be produced during a survey or audit, there is no objective evidence that the required work has been completed. The deficiency is administrative rather than technical, but the outcome is often the same.
Maintaining accurate records becomes increasingly important as yachts move between owners, management companies, captains and engineering teams. Information gathered during one refit provides the starting point for the next, reducing uncertainty and allowing future decisions to be based on verified inspection history rather than assumption.
Delivering the Finished Programme
Major yacht rig refits are often judged by visible milestones. The mast is stepped, the yacht leaves the yard and another winter period comes to an end.
Those milestones represent only a small proportion of the work undertaken.
Behind every completed installation sits a programme involving manufacturers, surveyors, machine shops, transport companies, specialist contractors and shipyard teams, all contributing information, components and technical expertise at different stages of the project. Drawings evolve as dimensions are verified, bespoke components move through design, fabrication and proof load testing, survey requirements are satisfied, weather windows influence operational activities and commissioning continues until the rig has been validated under sail.
Very little of that complexity remains visible once the yacht returns to service.
The owner sees a yacht ready for the season. The crew inherit a rig that has been inspected, commissioned and documented. Future survey periods begin with a complete technical record rather than fragmented information.
That continuity is one of the most valuable outcomes of a well-managed refit.
No two projects follow exactly the same path. Every yacht presents its own technical challenges, operational constraints and engineering decisions. The process remains dynamic from the first planning meeting until the final sea trial because new information continues to emerge throughout the programme.
Managing those variables has become as much a part of modern rigging as the work carried out on the mast itself.
As yachts continue to evolve, so too does the role of the rigging team. Today’s major refits demand structural assessment, engineering input, bespoke fabrication, proof load testing, commissioning, certification and technical coordination across multiple disciplines. The rig is only one element of the programme.
Delivering it successfully depends on understanding how every part of that programme influences the next.
